Pennsylvania Logged 100 Data Center Proposals. Five Cleared Permitting.

Residents packed into a rural county meeting room holding hand-lettered protest signs while officials review a data center site plan on a projector screen

Josh Shapiro just moved local approval ahead of state review. Community consent is no longer a public-relations problem the AI buildout manages on the side. It is the gate, and a short list of companies is now organized to pass through it.

Big Tech is spending on community funds, open houses and job guarantees because local consent has become a permitting prerequisite rather than a reputational nicety. Pennsylvania’s August 18 executive order makes local land-use approval a condition of state permit review, and New York’s June law requires host-community benefit programs by statute. The spending is small against capex. The capability behind it is not, and that is what reshapes who gets to build.

About 1,000 people filled the Effingham College & Career Academy in Rincon, Georgia in July to hear what OpenAI planned to do with 2,600 acres up the road. Protesters worked the entrance with signs reading “I didn’t vote for AI” and “You can’t drink data!!!” Inside, staff ran booths, QR codes pointed at a job board, and someone had set out a taco bar.

The tacos are not the story. The $20 billion behind them, and the four buildings OpenAI wants to fill with 3.2 gigawatts of Georgia Power electricity, arrive with a $80 million community fund and a promise of feedback sessions that will produce something called a Georgia Community Compact. Six years ago the same project would have been negotiated under a nondisclosure agreement and announced after the concrete was poured.

What Happened

The Wall Street Journal reported this week on the industry’s scramble to buy back public goodwill: listening sessions, guaranteed jobs, clean-water investments, multimillion-dollar pledges. Meta launched a $1 billion “Future Is For Everyone” fund in early August, against a prior community grant program that had distributed roughly $94 million in total. Amazon says it has put more than $1 billion into community partners over three years. Microsoft ended its use of nondisclosure agreements with local governments on March 18, the first major operator to do it.

Then Pennsylvania moved. On August 18 Governor Josh Shapiro signed Executive Order 2026-05, implementing what his office calls the GRID Requirements. He pulled every data center project out of the state’s fast-track permitting program, including Amazon’s, and closed the program to future data center applicants. He told reporters the standards are binding. His Department of Environmental Protection secretary, Jessica Shirley, spelled out the mechanism: developers who skip the requirements will not have their permit applications reviewed until they obtain local land-use approval first.

Shapiro had been an early champion of the sector, including a $20 billion Amazon commitment. He described developers as predatory and running roughshod over communities, and said he would not be bulldozed by their lawyers.

The order also disclosed a number nobody had put together before.

The Backstory

Buried in the governor’s announcement is a project census. Over the past year, DEP became aware of more than 100 data center proposals in publicly sourced databases. Fifty-eight of those engaged with the department on permitting at some level of formality. Fifteen applied for at least one permit. Five obtained everything they needed for their first phase of development.

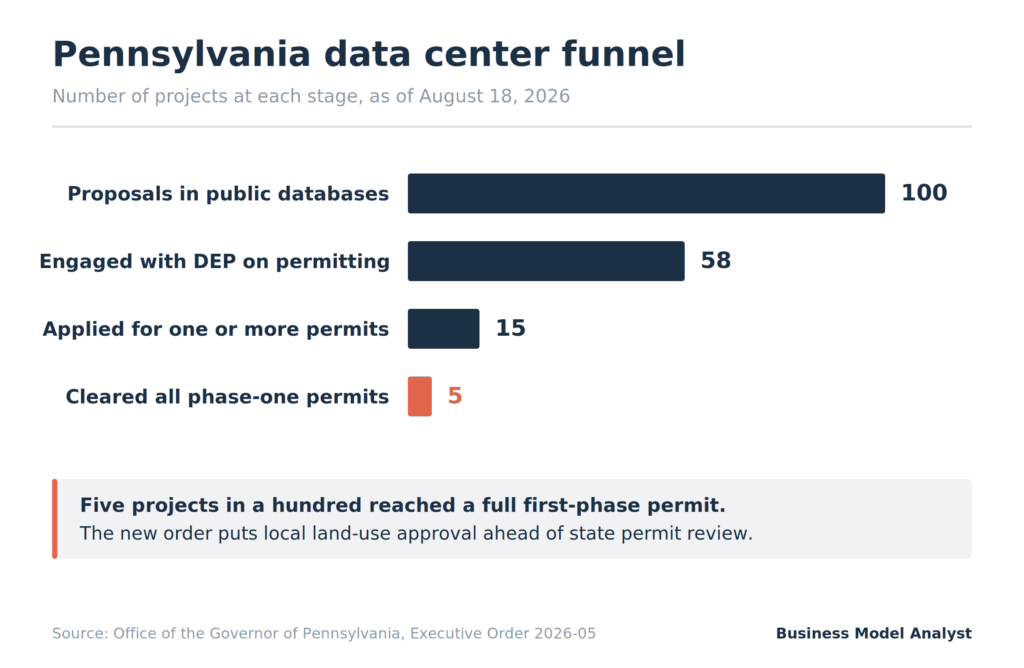

Bar chart of Pennsylvania's data center funnel showing 100 proposals in public databases, 58 engaged with the state environmental agency, 15 permit applications filed and 5 projects fully permitted for phase one

That is a 5% conversion rate under the old rules, in a state that was actively courting the industry. The attrition did not happen at the capital layer. Money was never the constraint. Projects died in townships.

Public opinion explains why. Gallup surveyed 1,000 US adults between March 2 and 18 and found 71% opposed to construction of an AI data center in their local area, with 48% strongly opposed. In the same survey, 53% opposed a local nuclear plant. Since Gallup first asked the nuclear question in 2001, the highest opposition ever recorded was 63%. Data centers are less welcome in American neighborhoods than nuclear power has been at any point this century.

Data Center Watch counted 75 US projects worth roughly $130 billion blocked or delayed in the first quarter of 2026, the largest single quarter on record. Organized opposition groups went from 396 at the end of 2025 to 833 across 49 states by March.

The Plan

The industry’s answer has three parts, and they cost very different amounts.

The cash is real but modest. OpenAI’s $80 million runs over the life of a $20 billion project. Meta’s $1 billion sits against a 2026 capital budget of $130 billion to $145 billion. We ran the arithmetic on that fund when Zuckerberg announced it, and the finding holds: these are rounding errors written in a font large enough to read from the back of a school gymnasium.

The scrip is cheaper still. OpenAI’s Georgia package headlines at $151 million, but $71 million of it is Codex credits, issued at $100 per student through ChatGPT accounts. That ceiling implies 710,000 individual allocations. Georgia’s public university system enrolled about 382,000 students last fall and its technical college system about 149,000. Add every private institution in the state and the total lands near 600,000. OpenAI set the maximum above the number of people eligible to claim it, which is what “up to” was doing in the press release. And the credits cost the company inference, not dollars. Half the headline is denominated in a currency OpenAI prints and priced at a retail rate almost nobody pays.

The procedural concessions cost nothing on the P&L and everything in the schedule. Microsoft’s NDA decision, its January Community-First AI Infrastructure Plan, the White House ratepayer pledge signed by seven companies with no enforcement mechanism attached. Each one converts a private negotiation into a public one and adds months.

Brad Smith told the Journal when the calculus changed. Not the protests. The New Jersey governor’s race last November, where Mikie Sherrill campaigned on electricity prices and won. Two months later Microsoft published its commitments. Protests had been running all through 2025 with no comparable response. The industry priced political risk on the day it changed who holds the pen.

The Business Model Angle

Read the spending as damage control and it looks wasteful. Read it as capability building and it looks like something else.

Consent has moved position in the sequence. It used to sit downstream of siting, a reputational cleanup you handled in parallel with engineering. Pennsylvania has now placed it upstream of the state permit itself, and New York’s Responsible Data Center Development Act, passed June 4, requires host-community benefit programs for projects above 20 megawatts as a matter of law. Once a legislature writes the benefit into statute, it stops being a voluntary flex and becomes a compliance line every developer must carry.

Compliance functions with organizational overhead consolidate industries. That is the pattern in mining, in pipelines, in utility siting, and it is arriving here.

Consider what OpenAI actually deployed in Effingham County. A chief global affairs officer. A communications director collecting resident input. Staff to design a compact, negotiate it with a county board, and be around in 2046 to honor it. Meta says it will sit down with school superintendents and police chiefs in each host community. Microsoft coordinated the termination of existing NDAs across its entire municipal footprint.

None of that scales down. A developer with three projects cannot amortize a government-affairs department across them. A private-equity-backed platform with a seven-year hold cannot credibly promise a school district anything on a 30-year asset life, which is the horizon a county commissioner is being asked to accept. The counterparty question matters more than the check size, and it is the question the biggest balance sheets answer best.

The jobs argument will not close the gap either. Project Camellia promises 400 permanent positions on $20 billion of capital, or $50 million of capex per permanent job. Meta’s Hyperion campus in Richland Parish runs about 1,000 permanent roles on more than $50 billion. Two unrelated projects, the same order of magnitude. Whatever data centers are, they are not employment programs, and residents worked that out before the consultants did. Meta’s $115 million skilled-trades academy addresses the construction labor shortage, which is a separate problem with a separate constraint.

The Risk

The barrier-to-entry read has a serious counterargument, and it starts with the size of the checks. Consent spending runs well under 1% of project capital. A well-funded independent developer can write that. If the money were the moat, it would be a thin one.

Goldman Sachs offers a harder objection. Historically about 72% of scheduled data center capacity comes online on schedule. For AI capacity slated between now and 2028, Goldman expects roughly half to hit its target date. Interconnection queues, turbine lead times and transformer backlogs explain more of that slippage than any township vote. Solve consent and the projects still wait on the grid.

Ben Green at the University of Michigan points to a third problem, one that cuts against the companies rather than the thesis. They say they want to be good neighbors while fighting moratorium bills and regulations in the same states. If they believed consent were expensive, they would take the statute and stop litigating. Their behavior suggests they still think the checks are the cheaper option.

There is also a repricing risk running the other way. Pennsylvania’s legislature came close to killing the state’s data center sales-tax exemption last session and will try again; Food & Water Watch estimates the exemption will cost the commonwealth more than $2 billion by mid-2031. States are already pulling incentives back across roughly two dozen legislatures. If the tax break disappears while the benefit obligation stays, the arithmetic that made a county attractive stops working, and the buildout relocates rather than consolidates.

And a compact signed with the tenant is not a compact signed with the owner. Meta holds 20% of Hyperion and leases from Blue Owl; BlackRock owns 80% of the El Paso campus. County officials negotiating with a brand name may find the deed in a different vehicle.

Quick Questions

Why are tech companies suddenly holding open houses for data centers? Because local approval now gates state permitting in a growing number of jurisdictions. Pennsylvania’s August 18 executive order makes DEP review conditional on local land-use approval, and New York requires host-community benefit programs by law above 20 megawatts.

How much are companies paying for community consent? OpenAI committed $80 million in cash plus up to $71 million in Codex credits on a $20 billion Georgia project. Meta launched a $1 billion fund against $130 billion to $145 billion of 2026 capex. Amazon reports more than $1 billion to community partners over three years.

Do data centers create many local jobs? Few permanent ones. OpenAI’s Georgia project projects 400 permanent positions on $20 billion of capital, about $50 million of capex per job. Construction employment is large and temporary.

Which states are restricting data centers? Pennsylvania issued the GRID executive order in August 2026, New York passed a permit freeze above 20 megawatts in June and Governor Hochul added an executive order in July. Roughly two dozen legislatures have moved on incentives or siting rules. Our state-by-state breakdown tracks the rollbacks.

Will the backlash stop the AI buildout? Unlikely. Goldman Sachs attributes most schedule slippage to grid interconnection and equipment lead times rather than local opposition. The backlash changes where projects land and who can afford to land them.

The Business Model Analyst Take

Every extractive industry eventually learns that the permit is the product. Miners learned it, pipeline operators learned it, and the hyperscalers are learning it now at a cost of about seven figures per county and one election cycle of lost political cover.

The interesting part is not the money. It is that Microsoft, Amazon, Meta and OpenAI are all building the same new function at the same time: a standing political operation capable of negotiating, documenting and honoring 30-year local commitments in dozens of jurisdictions at once. That function has fixed costs, it takes years to staff, and it does not exist inside a merchant developer. Shapiro did not slow the AI buildout on Tuesday. He raised the price of the ticket, and four or five companies already bought season passes.

Watch two things. Whether Pennsylvania’s local-approval-first sequencing gets copied, because that is the change that converts consent from an expense into a gate. And whether any operator starts publishing per-site benefit figures with allocation formulas and end dates attached. Right now the pledges are announced in aggregate with no term, which is a call option dressed as a covenant. The first company to publish an enforceable schedule will find out whether communities were ever pricing the money at all, or whether they were pricing the promise.

UNLOCK THIS FREE DOWNLOAD

DOWNLOAD NOW

Fill Your E-mail to Receive this Download Directly in Your Inbox.

RECEIVE OUR UPDATES

The Biz Model Club

Get daily, no-fluff insights on the latest business models, startup strategies, and trends delivered straight to your inbox.
